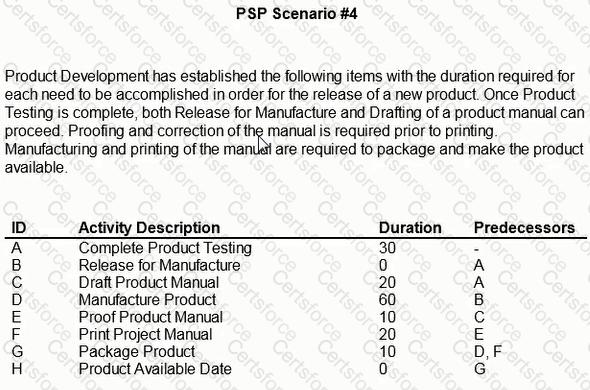

How much Total Float does drafting the product manual have?
The data date or status date of a schedule represents the:
Which of the following are NOT normally included in the project scope statement, either directly or by reference?
How many workdays occur from the start of the Product Testing to the Product Available milestone?
What portion of Activity B is on the critical path?
What is a key first step in developing a critical path method schedule?

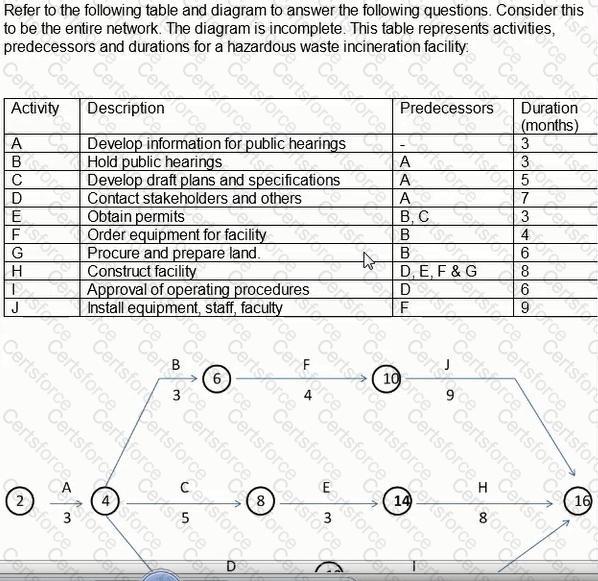

These are the activities on the critical path:
How could the structural steel drawing delay have been prevented?
Identify the minimum project duration.

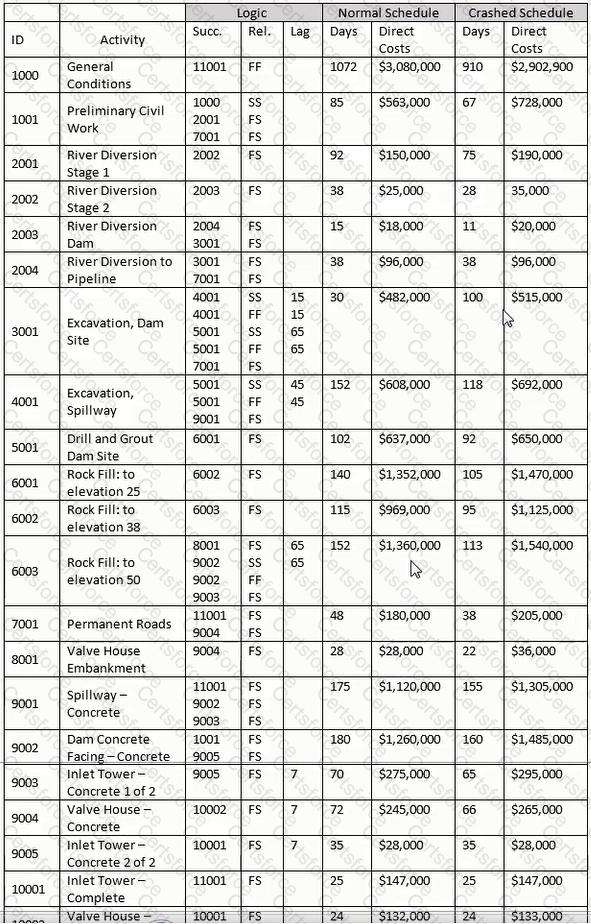

Determine the correct formula and date for the late start for Activity 9001.
