Questions # 21:

What is a critical path method schedule?

Options:

A.

List of work to be accomplished by responsible party and when it is to be accomplished


B.

The timeline of the riskiest work


C.

A graphical means of showing the important work


D.

A network diagram of logically interconnected activities


Expert Solution
Questions # 22:

If after calculating a schedule an activity exhibits negative total float, which of the following is certain? The activity

Options:

A.

Is a milestone.


B.

It is on the critical path.


C.

Was completed in the past.


D.

Has yet to be completed.


Expert Solution
Questions # 23:

Using the "normal" schedule, and assuming you are billing on the last day of the month for previous month and for appropriate partial months, how many invoices will you have for this project?

Options:

A.

42.


B.

36.


C.

40.


D.

37.


Expert Solution
Questions # 24:

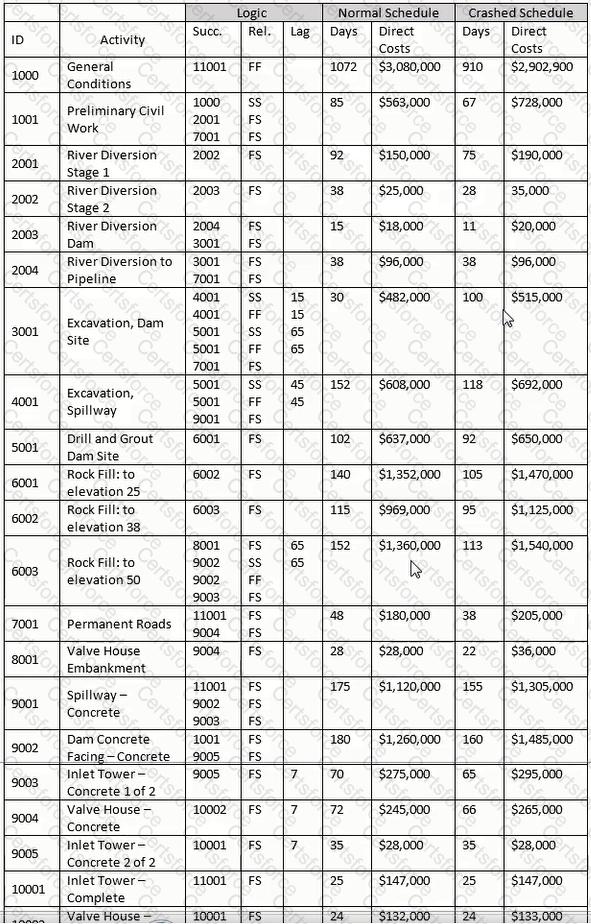

What is accurate about Activity 7001 in the precedence diagram?

Options:

A.

The successor FF lag from 7001 to 11001 is not shown


B.

The LF is correct


C.

The TF is not calculated correctly


D.

The LF is not correct


Expert Solution
Questions # 25:

For activity 11001. why would the crashed direct cost be greater than the direct cost of the normal schedule?

Options:

A.

Additional extended overhead is also being shown in this activity


B.

Some costs resulting from the crashed efforts were forgotten in previous activities


C.

Generally, more equipment is used for a crashed project; therefore, it costs more to demobilize


D.

Management bonuses for early completion were included in this activity


Expert Solution
Questions # 26:

If someone wanted to constrain a project's end date so that any project slippage would cause negative float, they would do so by using

Options:

A.

Finish-no-earlier constraint on the first activity


B.

Finish-no-earlier constraint on the last activity


C.

Finish-no-later constraint on the last activity


D.

Start-no-later constraint on the first activity


Expert Solution
Questions # 27:

If all other work proceeds according to the Baseline plan, how many times will the critical path change?

Question # 27

Options:

A.

2.


B.

1.


C.

Does not change.


D.

3.


Expert Solution
Questions # 28:

Determine the correct formula and date for the late finish for Activity 6002.

Options:

A.

LS of 6003 plus 1 day equaling 09 Mar 2023


B.

LS of 6003 less 1 day equaling 09 Mar 2022


C.

LS of 6003 less 1 day equaling 09 Mar 2023


D.

LS of 6003 plus 1 day equaling 09 Mar 2022


Expert Solution
Questions # 29:

Why does activity 1001 have two successor activities?

Question # 29

Options:

A.

Because the late finish of 1001 and the late start of 7001 require two successors


B.

Because the problem could not effectively work with only one successor


C.

Because there are two defined logic paths for the work


D.

Because the duration of activities 2001, 2002 and 200.f require two successors


Expert Solution
Questions # 30:

Which letter of the alphabet best approximates the graphical shape of a project's cumulative cost baseline, or budgeted cost of work scheduled?

Options:

A.

C.


B.

B.


C.

S.


D.

W.


Expert Solution
